Quick answers
What does a SOC 2 risk assessment include? Each risk needs an ID, description, category, likelihood, impact, treatment plan, and mapping to mitigating controls.
How does AI help with risk assessment? AI structures and categorizes risks, maps them to controls, and maintains the risk register in machine-readable format.
How many risks should you track? We track 42 across three categories: People, Technical, and Policy. The number matters less than the coverage.
42 risks. Each with an owner, a treatment plan, and controls that mitigate it. That is what a functioning risk register actually looks like.
Not a clunky spreadsheet with color-coded cells and half-empty columns. Not a compliance platform’s auto-generated risk list that nobody reads after setup. A living document where every identified risk connects to specific controls, carries an assessed severity, and has a clear treatment strategy. I am skeptical of how most compliance vendors sell risk assessment - they market the spreadsheet template and skip the part where the template silently goes stale within a quarter.
At Tallyfy, we maintain our entire SOC 2 risk assessment in YAML files inside a Git repository. When our auditors need to verify that we’ve identified and assessed risks per CC3.1 and CC3.2 of the Trust Services Criteria, we point them at structured data that hasn’t been corrupted by someone accidentally deleting a row in Excel.
This is the approach we use across our entire SOC 2 compliance system. Here’s how the risk assessment piece works.
Risks have to trace back to controls and evidence. The bridge document that carries that traceability is the Control to Evidence Mapping PDF:
Seven pages, 151 control-to-evidence relationships, auto-generated from the same YAML that powers both the Control Matrix and the Risk Register. Each of our 42 risks maps to one or more of these controls, which in turn map to evidence items. See the full workflow in our live audit walkthrough.
What does a risk assessment actually require?
Hmm, let me unpack what they actually want. SOC 2 auditors don’t want a casual list of things that worry you. The AICPA’s Common Criteria spell out what a proper risk assessment demands. CC3.1 requires you to specify objectives clearly enough that you can identify risks against them. CC3.2 requires you to identify those risks across the entire entity and analyze them as a basis for deciding how to manage each one. In building Tallyfy’s compliance program over the last decade, the pattern that keeps showing up is that founders read “risk assessment” and picture a single document, when the auditor is really looking for evidence of an ongoing analytical posture.
In practice, every risk in your register needs these fields:
- A unique identifier. Not “Risk 1” or “R-047.” Something descriptive that tells you what the risk actually is.
- A plain-language description. What could go wrong and why it matters.
- A category. Grouping risks makes patterns visible. You can’t spot gaps if everything sits in a flat list.
- Likelihood and impact scores. How probable is this risk? How bad would it be? Auditors expect a documented scoring methodology that you apply consistently.
- A treatment strategy. Are you controlling it, transferring it, accepting it, or avoiding it altogether?
- Mitigating controls. Which specific controls reduce this risk to an acceptable level?
- Current status. Is the risk mitigated, open, or under review?
Here’s what a single risk entry looks like in our YAML register:
- id: change-management
name: Change Management
description: Changes without appropriate oversight introduce vulnerabilities
treatment: CONTROL
status: MITIGATED
category: Technical
impact: LOW
likelihood: LOW
combined_score: LOW
mitigating_controls:
- Change Management Process
- Separation of EnvironmentsEvery field is explicit. Nothing is implied. An auditor can read this without any explanation, and so can a script that generates compliance reports.

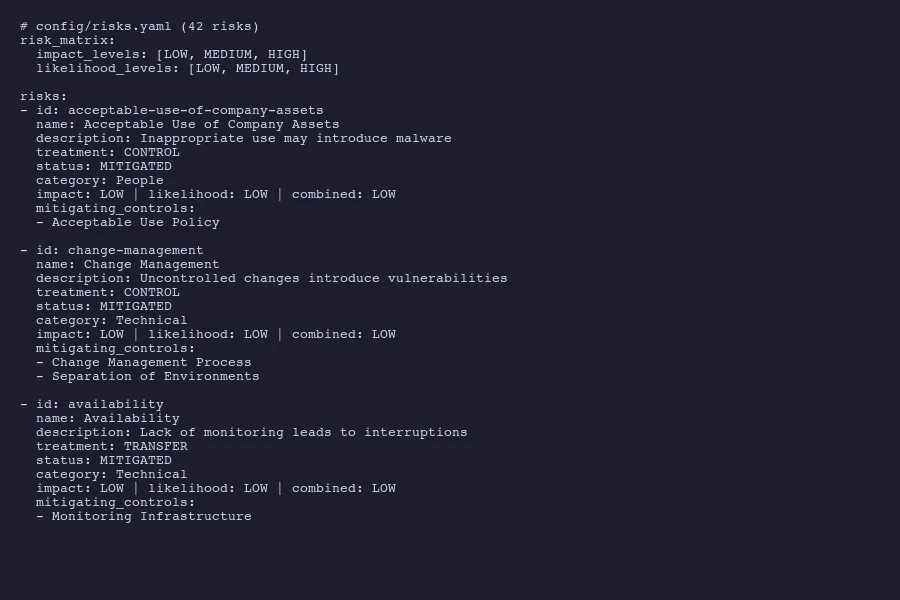

Risk entries from our risks.yaml with treatment plans and mitigating controls
The three risk categories that cover everything
We organize our 42 risks into three buckets: People, Technical, and Policy. Are three categories enough? For a SaaS company, yes. After mulling this over against the alternative schemes (five-tier, seven-tier, the ISO 31000 taxonomy), three holds up because it maps to how risks actually originate in a SaaS organization rather than how a textbook prefers to slice them.
People risks cover human factors. Employees using company assets inappropriately. Social engineering attacks succeeding because someone clicked the wrong link. Access persisting after someone leaves the company. Inadequate security training. Insider threats. These risks exist because humans are involved, and they’re mitigated by policies, training, and access controls.
- id: acceptable-use-of-company-assets
name: Acceptable Use of Company Assets
description: Inappropriate use of company owned assets may introduce malware or viruses
treatment: CONTROL
status: MITIGATED
category: People
impact: LOW
likelihood: LOW
combined_score: LOW
mitigating_controls:
- Acceptable Use PolicyTechnical risks address infrastructure and application-level concerns. Availability failures from poor capacity management. Vulnerabilities introduced through uncontrolled code changes. Data breaches from weak encryption. Network intrusions. System monitoring gaps. These get mitigated by technical controls like monitoring, change management processes, and separation of environments.
- id: availability
name: Availability
description: Lack of capacity management can lead to service interruptions
treatment: TRANSFER
status: MITIGATED
category: Technical
impact: LOW
likelihood: LOW
combined_score: LOW
mitigating_controls:
- Monitoring InfrastructureNotice the treatment type there. TRANSFER, not CONTROL. We run on cloud infrastructure, so availability risk gets partially transferred to our cloud provider through their SLAs. The risk treatment decision matters because auditors want to see that you thought about it, not just that you listed a risk and slapped “mitigated” on it.
Policy risks capture organizational and procedural gaps. Business continuity planning. Incident response readiness. Vendor management. Regulatory compliance. These risks exist at the governance level and get mitigated by documented policies that people actually follow. What makes this useful is this layer is that the policies cost almost nothing to write and almost everything to enforce - which is precisely backwards from how budgets get allocated.
- id: business-continuity
name: Business Continuity
description: Organization may not resume operations after catastrophic event
treatment: CONTROL
status: MITIGATED
category: Policy
impact: LOW
likelihood: LOW
combined_score: LOW
mitigating_controls:
- Disaster Recovery Plan
- Restore
- Business ContinuityThree categories. Proper separation. Every risk lands in exactly one bucket, and that bucket tells you the general shape of the mitigation strategy before you even read the details.
I said up there that “the number matters less than the coverage.” That oversimplifies it. The number does matter, just not in the way most people assume. A 12-risk register at a 50-person SaaS company usually signals an incomplete pass through the entity (CC3.2 wants every layer covered). A 200-risk register usually signals that someone confused “risk” with “any threat in the threat catalog.” 42 is not magic. 30 to 60 is the band where most healthy mid-size SaaS programs land after they have actually walked the entity end to end. If you are far outside that band in either direction, the assessment probably needs another look. If you want to think about this for your own compliance program, get in touch.

42 risks distributed across People, Technical, and Policy categories
If you want help shaping the actual implementation, Blue Sheen runs engagements like this.
The risk matrix that auditors want to see
Auditors want a documented risk matrix. The AICPA framework expects you to assess each risk on two dimensions: how likely it is to occur and how severe the impact would be.
We use a simple three-level scale. LOW, MEDIUM, HIGH. Some organizations use five-level or even ten-level scales. More granularity isn’t necessarily better. Actually, that oversimplifies it. The point is consistency. If you rate one risk as MEDIUM likelihood, the same reasoning should apply to every risk rated MEDIUM.
The combined score follows a straightforward matrix:
| LOW impact | MEDIUM impact | HIGH impact | |
|---|---|---|---|
| LOW likelihood | LOW | LOW | MEDIUM |
| MEDIUM likelihood | LOW | MEDIUM | HIGH |
| HIGH likelihood | MEDIUM | HIGH | HIGH |
All 42 of our risks currently score LOW combined. That’s not because we’re ignoring threats. It’s because every identified risk has mitigating controls in place that reduce both the likelihood and the impact to acceptable levels. Hard to believe any organization with a healthy program ever sees a register where everything stays HIGH for long - if it does, the program is the problem, not the risks.

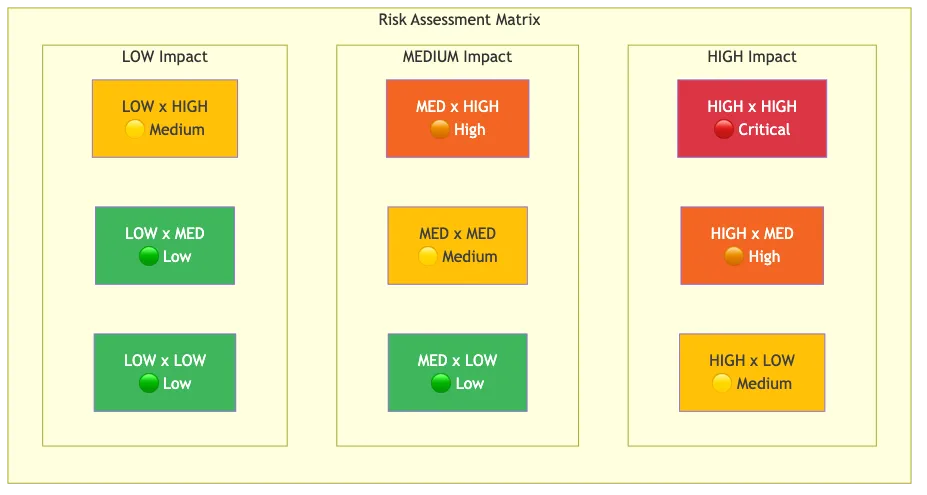

Risk assessment matrix mapping impact against likelihood
And, “acceptable” isn’t wishful thinking. It means the controls are documented, implemented, tested, and producing evidence that auditors can examine. A risk scored LOW with no controls is a red flag. A risk scored LOW with two or three specific controls mapped to it is a functioning risk management program. The controls then connect to evidence collection that proves each one operates effectively.
The matrix also helps surface risks that need attention. If a control fails or weakens, the risk score shifts. A MEDIUM combined score on any risk triggers a review. A HIGH score requires a formal treatment plan with a timeline and an owner. The YAML structure makes this trivially easy to query and filter, which is something you can’t say about a color-coded Excel heatmap.
Mapping risks to mitigating controls
The thing is, this is where most risk assessments fall apart. In advisory work with mid-size operations teams, the failure pattern is almost cinematically identical: companies list risks in one document and controls in another, with no explicit connection between them. An auditor asks “what controls mitigate your change management risk?” and someone has to manually trace the relationship across multiple spreadsheets. Watching that scramble play out in real time is painful to sit through.
Our YAML structure solves this by embedding the control mapping directly in each risk entry. The mitigating_controls field is a list of specific control names. Those same names appear in our controls register, creating a bidirectional link. Start from a risk and you can see every control that addresses it. Start from a control and you can see every risk it mitigates.
This is where AI proves useful. When we add a new risk or modify an existing one, AI reviews the full controls inventory and suggests which controls apply. It catches connections that humans miss. A risk about “unauthorized system access” might be mitigated by access control policies as well as monitoring infrastructure, employee onboarding procedures, and regular access reviews. Turns out, AI surfaces those less obvious relationships because it can hold the entire register in context simultaneously. We use this same approach for AI-assisted evidence collection across the full compliance program.
The mapping also reveals coverage gaps. If a control only mitigates one risk, that’s fine. If a risk has zero mitigating controls, that’s a problem. If ten risks all depend on a single control, that control becomes critical infrastructure for your compliance program.
Here’s a real example of multi-control mitigation:
- id: change-management
name: Change Management
description: Changes without appropriate oversight introduce vulnerabilities
treatment: CONTROL
status: MITIGATED
category: Technical
impact: LOW
likelihood: LOW
combined_score: LOW
mitigating_controls:
- Change Management Process
- Separation of EnvironmentsTwo controls. One ensures changes go through review and approval. The other ensures development, staging, and production environments stay separate so untested changes can’t reach customers. Together they reduce both the likelihood and impact of uncontrolled changes. Neither alone would be sufficient.
This is the thinking auditors are keen to see. Beyond “we have controls” - “we understand which risks each control addresses and why that combination is sufficient.” The NIST Risk Management Framework is built on the same connection - control selection in its seven-step process flows directly from the risk assessment.
Why structured data beats risk assessment spreadsheets
An analysis from Wissda documented four recurring failure modes in spreadsheet-based risk management: siloed data that limits enterprise risk coverage, low data integrity from manual entry errors, delayed risk identification and response, and lack of real-time risk intelligence.
We’ve seen all of these firsthand. Before switching to YAML, our risk register lived in a shared spreadsheet that had been cobbled together from three earlier templates - a classic scope creep artifact. Someone added a risk without filling in the treatment column. Someone else changed a control name in the controls sheet but not in the risk register, breaking the mapping. Conditional formatting hid empty cells. The auditor flagged three risks with missing mitigating controls that turned out to be formatting issues, not actual gaps. Two hours of everyone’s time wasted. Painful.
This is where it gets tricky for teams who inherited the spreadsheet from a predecessor: the formatting tricks are invisible until they break, and the break always happens during audit week. Structured data eliminates entire categories of these problems. Kind of a no-brainer, once you see it laid out.
Version control. Every change to the risk register creates a Git commit with a timestamp, author, and description. Auditors can see exactly who modified a risk assessment and when. Try doing that with a shared spreadsheet. They also expect the assessment to be reviewed and updated within the audit period. Git history proves that definitively.
Validation. A YAML schema can enforce required fields. If someone adds a risk without a treatment strategy, the validation fails. No more half-completed entries lurking in your register.
Automation. Scripts can generate risk matrices, calculate coverage statistics, and produce auditor-ready reports from the same YAML source. Our AI tooling generates compliance narratives directly from the structured data. NIST has been pushing toward machine-readable compliance formats through OSCAL for exactly this reason.
Querying. Want all Technical risks with MEDIUM or higher combined scores? That’s a one-line filter. Want all risks mitigated by the Acceptable Use Policy? Another one-line query. In a spreadsheet, these questions require manual sorting, filtering, and hoping nobody hid any rows.
Consistency. The YAML structure enforces a uniform format. Every risk has the same fields. Every treatment uses the same vocabulary (CONTROL, TRANSFER, ACCEPT). Every category draws from the same set. Spreadsheets drift. Structured data doesn’t.
The compliance-as-code movement is heading this direction broadly. Embedding compliance checks into development pipelines, expressing requirements in machine-readable formats, treating security controls as testable assertions rather than checkbox documentation. Our risk register in YAML is a small but concrete expression of that principle.
42 risks. Three categories. Explicit control mappings. Machine-readable format with full version history. That’s what a functioning SOC 2 risk assessment looks like when you stop treating compliance as paperwork and start treating it as structured data.
“Spreadsheets are passed around on email. Risk registers are updated quarterly - if someone remembers.” — Shruti Sharma, Wissda, why spreadsheet risk management fails
